Tutorial: Create a status update workflow

In this end-to-end tutorial, you create a translytical task flow that tracks project status, writes updates back to a database, and posts notifications from a Power BI report to Microsoft Teams. The solution maintains a complete history of all status updates, so you can track how project status has changed over time. This tutorial demonstrates how to combine data write-back with external API calls to create a complete communication workflow.

In this tutorial, you learn how to:

  • Create a SQL database in Fabric with project and status tracking tables that maintain full history.
  • Set up a variable library to store configuration separately.
  • Configure user data functions that update status, request updates, and post notifications to Teams.
  • Optionally set up Lakehouse shortcuts with materialized lake views for Direct Lake views.
  • Integrate user data functions with a Power BI report using data function buttons.

If you don't have an existing Fabric capacity, start a Fabric trial.

Prerequisites

  • Power BI Desktop. If you don't have Power BI Desktop installed on your device, follow the instructions in Get Power BI Desktop.
  • A Microsoft Teams channel where you have permission to add incoming webhooks.

Overview

This tutorial creates a project tracking solution where users can update project status directly from a Power BI report. When a user updates a status, the system:

  1. Writes the new status to the SQL database, maintaining a complete history of all status updates.
  2. Sends an Adaptive Card notification to Microsoft Teams.
  3. Refreshes the report to show the updated data.

User flow

The workflow creates a continuous feedback loop between report users:

  1. Request update via Teams from report — A user selects a project in the report and sends a status update request. The request posts to Teams with a link back to the report.

  2. Receive notification in Teams and open report — The project owner sees the notification in Teams and selects the link to open the report.

  3. Update status in report — The project owner selects the project, chooses a new status, adds notes, and selects the update button.

  4. See real-time update and send notification — The report refreshes immediately to show the new status, and a notification posts to Teams confirming the change.

Architecture

The solution connects these components within Microsoft Fabric:

Component Purpose
Fabric SQL Database Stores project and status update records with full history. Contains the Project table, Status updates table (which maintains a complete history of all changes), and Project status view.
Lakehouse (optional) Provides shortcuts to the SQL database tables for Direct Lake views. Use when you need materialized lake views for analytics.
Variable Library Stores configuration values like the Teams webhook URL and report URL. Update values without republishing functions.
User Data Functions Python functions that handle the write-back to SQL and post notifications to Microsoft Teams via Adaptive Cards.
Power BI Semantic Model Defines the data model, relationships, and measures. Built with the report in Power BI Desktop, but exists as a separate item in the Power BI service.
Power BI Report The user interface where users view projects, select new statuses, and trigger updates via data function buttons.
Microsoft Teams Receives Adaptive Card notifications with status changes and links back to the report.

The data flows in two directions:

  • Read path: Power BI reads from the SQL database (via DirectQuery) or Lakehouse (via Direct Lake) to display current project status.
  • Write path: When a user selects a data function button, Power BI calls the user data function, which writes to the SQL database and posts to Teams.

Create a SQL database

This scenario uses project tracking data. Follow the steps in Create a SQL database in Fabric to create a new SQL database in your Fabric workspace.

Create the database tables

  1. In your SQL database, open a new query window.

  2. Run the following SQL script to create the Project table:

    CREATE TABLE [Project] (
        [Project id] INT NOT NULL,
        [Project name] NVARCHAR(200) NOT NULL,
        [Product name] NVARCHAR(200),
        [Description] NVARCHAR(4000),
        [Priority] NVARCHAR(20),
        [Start date] DATE,
        [Target end date] DATE,
        [Budget] DECIMAL(18,2),
        [Project manager] NVARCHAR(100),
        [Department] NVARCHAR(100),
        [Created date] DATETIME2,
        [Created by] NVARCHAR(100),
        [Is active] BIT,
        CONSTRAINT PK_Project PRIMARY KEY NONCLUSTERED ([Project id])
    );

  3. Create the Status updates table to track status changes over time:

    CREATE TABLE [Status updates] (
        [Update id] INT NOT NULL,
        [Project id] INT NOT NULL,
        [Status] NVARCHAR(50) NOT NULL,
        [Updated date] DATETIME2 NOT NULL,
        [Updated by] NVARCHAR(100) NOT NULL,
        [Notes] NVARCHAR(4000),
        CONSTRAINT PK_StatusUpdates PRIMARY KEY NONCLUSTERED ([Update id])
    );

  4. Create a view that returns the latest status for each project:

    CREATE VIEW [Project status] AS
    SELECT
        p.[Project id],
        p.[Project name],
        COALESCE(ls.[Latest status], 'Not Started') AS [Latest status],
        ls.[Latest notes]
    FROM [Project] p
    LEFT JOIN (
        SELECT
            [Project id],
            [Status] AS [Latest status],
            [Notes] AS [Latest notes],
            ROW_NUMBER() OVER (PARTITION BY [Project id] ORDER BY [Update id] DESC) AS RowNum
        FROM [Status updates]
    ) ls ON p.[Project id] = ls.[Project id] AND ls.RowNum = 1;

  5. Insert sample project data:

    INSERT INTO [Project] ([Project id], [Project name], [Product name], [Description], [Priority], [Start date], [Target end date], [Budget], [Project manager], [Department], [Created date], [Created by], [Is active])
    VALUES
    (1, 'Best Practices with Power BI - FabCon Atlanta', 'FabCon Atlanta', 'Session covering Power BI best practices for enterprise deployments', 'High', '2026-01-15', '2026-03-20', 5000.00, 'person1@somecompany.com', 'Developer Relations', '2026-01-15', 'Admin', 1),
    (2, 'Translytical Task Flows - Build', 'Microsoft Build', 'Deep dive into translytical workloads and real-time analytics patterns', 'Critical', '2026-02-01', '2026-05-19', 7500.00, 'person2@somecompany.com', 'Product Engineering', '2026-02-01', 'Admin', 1),
    (3, 'Advanced DAX Patterns - FabCon Barcelona', 'FabCon Barcelona', 'Workshop on complex DAX calculations and optimization techniques', 'High', '2026-03-01', '2026-09-15', 6000.00, 'person1@somecompany.com', 'Developer Relations', '2026-02-20', 'Admin', 1),
    (4, 'Semantic Modeling Deep Dive - Ignite', 'Microsoft Ignite', 'Comprehensive session on semantic model design and best practices', 'High', '2026-01-10', '2026-11-18', 8000.00, 'person2@somecompany.com', 'Product Engineering', '2026-01-10', 'Admin', 1),
    (5, 'Custom Visuals in Power BI - FabCon Atlanta', 'FabCon Atlanta', 'Hands-on lab for building custom visuals with the Power BI SDK', 'Medium', '2025-12-01', '2026-03-20', 4500.00, 'person1@somecompany.com', 'Developer Relations', '2025-12-01', 'Admin', 1),
    (6, 'TMDL for Version Control - Build', 'Microsoft Build', 'Session on using TMDL for semantic model source control and CI/CD', 'Critical', '2025-11-15', '2026-02-15', 5500.00, 'person2@somecompany.com', 'Product Engineering', '2025-11-15', 'Admin', 1),
    (7, 'Real-time Analytics with Power BI - Ignite', 'Microsoft Ignite', 'Showcase of Direct Lake and real-time streaming capabilities', 'High', '2026-02-10', '2026-11-18', 7000.00, 'person1@somecompany.com', 'Developer Relations', '2026-02-10', 'Admin', 1),
    (8, 'Semantic Modeling Workshop - FabCon Barcelona', 'FabCon Barcelona', 'Interactive workshop on building enterprise-grade semantic models', 'High', '2026-04-01', '2026-09-15', 6500.00, 'person2@somecompany.com', 'Product Engineering', '2026-02-25', 'Admin', 1);

  6. Insert sample status updates:

    INSERT INTO [Status updates] ([Update id], [Project id], [Status], [Updated date], [Updated by], [Notes])
    VALUES
    (1, 1, 'Not Started', '2026-01-15', 'person1@somecompany.com', 'Session abstract submitted and approved'),
    (2, 1, 'In Progress', '2026-01-25', 'person1@somecompany.com', 'Outline completed, starting slide deck'),
    (3, 1, 'In Progress', '2026-02-10', 'person1@somecompany.com', 'Demo environment setup in progress'),
    (4, 1, 'In Progress', '2026-02-25', 'person1@somecompany.com', 'First draft of presentation complete, scheduling dry run'),
    (5, 2, 'Not Started', '2026-02-01', 'person2@somecompany.com', 'Session proposal accepted for Build'),
    (6, 2, 'In Progress', '2026-02-08', 'person2@somecompany.com', 'Research phase - gathering customer scenarios'),
    (7, 2, 'In Progress', '2026-02-15', 'person2@somecompany.com', 'Architecture diagrams drafted'),
    (8, 2, 'In Progress', '2026-02-24', 'person2@somecompany.com', 'Building demo lakehouse environment'),
    (9, 3, 'Not Started', '2026-02-20', 'person1@somecompany.com', 'Call for speakers submission pending review'),
    (10, 4, 'Not Started', '2026-01-10', 'person2@somecompany.com', 'Initial brainstorming session with PM team'),
    (11, 4, 'In Progress', '2026-01-20', 'person2@somecompany.com', 'Content outline approved by leadership'),
    (12, 4, 'In Progress', '2026-02-05', 'person2@somecompany.com', 'Sample semantic models being developed'),
    (13, 5, 'Not Started', '2025-12-01', 'person1@somecompany.com', 'Lab environment requirements documented'),
    (14, 5, 'In Progress', '2025-12-15', 'person1@somecompany.com', 'SDK samples being prepared'),
    (15, 5, 'On Hold', '2026-01-10', 'person1@somecompany.com', 'Paused - waiting on SDK v5 release for new features'),
    (16, 6, 'Not Started', '2025-11-15', 'person2@somecompany.com', 'Session planning initiated'),
    (17, 6, 'In Progress', '2025-12-01', 'person2@somecompany.com', 'GitHub Actions workflow samples created'),
    (18, 6, 'In Progress', '2026-01-15', 'person2@somecompany.com', 'Dry run completed with internal team'),
    (19, 6, 'Completed', '2026-02-15', 'person2@somecompany.com', 'Session delivered at internal summit, ready for Build'),
    (20, 7, 'Not Started', '2026-02-10', 'person1@somecompany.com', 'Topic approved for Ignite breakout session'),
    (21, 7, 'In Progress', '2026-02-18', 'person1@somecompany.com', 'Eventstream demo scenarios identified'),
    (22, 7, 'In Progress', '2026-02-26', 'person1@somecompany.com', 'Direct Lake performance benchmarks in progress'),
    (23, 8, 'Not Started', '2026-02-25', 'person2@somecompany.com', 'Workshop format and duration confirmed');


Set up a variable library

A variable library stores configuration values separately from your function code. This separation provides a key benefit: you can update values like webhook URLs or report links without editing or republishing your user data functions.

For example, if your Teams channel changes or you need to point to a different report, update the variable library value and the change takes effect immediately—no code changes required.

  1. In your Fabric workspace, select + New item.

  2. Scroll down to the Develop data section and select Variable library.

  3. Name the variable library ProjectVariables and select Create.

  4. Select + New variable and add the following variables:

    Variable name Type Description
    TEAMS_WEBHOOK_URL String Your Teams incoming webhook URL
    POWERBI_REPORT_URL String URL to your Power BI report (added after publishing)
  5. Select Save after adding each variable.

Get a Teams webhook URL

Follow the steps in Create an Incoming Webhook to create a webhook for your Teams channel. After creating the webhook, copy the URL and add it to your variable library as TEAMS_WEBHOOK_URL.

Important

Anyone with this URL can post messages to your Teams channel.

Create the user data functions

Create a user data functions item that handles status updates and Teams notifications.

  1. In your Fabric workspace, select + New item > User Data Functions.

  2. Replace the default code with the following Python code:

    import fabric.functions as fn
    import logging
    from datetime import datetime

    udf = fn.UserDataFunctions()


    @udf.connection(argName="sqlDb", alias="ProjectTrackingDb")
    @udf.connection(argName="varLib", alias="ProjectVariables")
    @udf.function()
    def update_project_status(
        sqlDb: fn.FabricSqlConnection,
        varLib: fn.FabricVariablesClient,
        projectId: int,
        newStatus: str,
        updatedBy: str,
        notes: str,
        updatedDate: str
    ) -> str:
        """
        Updates the status of a project by inserting a new record
        into the Status updates table and sends a Teams notification.
        """
        logging.info(f"Updating status for Project ID: {projectId}")

        # Parse and validate the date
        try:
            parsed_date = datetime.fromisoformat(updatedDate)
        except ValueError:
            raise fn.UserThrownError(
                f"Invalid date format. Use ISO format: '2026-02-27T14:30:00'",
                {"providedDate": updatedDate}
            )

        # Validate status value
        valid_statuses = ['Not Started', 'In Progress', 'On Hold', 'Completed', 'Cancelled']
        if newStatus not in valid_statuses:
            raise fn.UserThrownError(
                f"Invalid status. Must be one of: {', '.join(valid_statuses)}",
                {"providedStatus": newStatus}
            )

        connection = sqlDb.connect()
        cursor = connection.cursor()

        try:
            # Get the previous status
            cursor.execute("""
                SELECT TOP 1 [Status]
                FROM [Status updates]
                WHERE [Project id] = ?
                ORDER BY [Update id] DESC
            """, (projectId,))
            prev_row = cursor.fetchone()
            previous_status = prev_row[0] if prev_row else "Not Started"

            # Get the next Update ID
            cursor.execute("SELECT ISNULL(MAX([Update id]), 0) + 1 FROM [Status updates]")
            next_update_id = cursor.fetchone()[0]

            # Verify the project exists
            cursor.execute("SELECT [Project name] FROM [Project] WHERE [Project id] = ?", (projectId,))
            project_row = cursor.fetchone()

            if not project_row:
                raise fn.UserThrownError(f"Project with ID {projectId} not found.")

            project_name = project_row[0]

            # Insert the new status update
            cursor.execute("""
                INSERT INTO [Status updates]
                ([Update id], [Project id], [Status], [Updated date], [Updated by], [Notes])
                VALUES (?, ?, ?, ?, ?, ?)
            """, (next_update_id, projectId, newStatus, parsed_date, updatedBy, notes))

            connection.commit()

            # Send Teams notification
            _send_teams_update(varLib, project_name, previous_status, newStatus, updatedBy, notes)

            return f"Status updated for '{project_name}': {previous_status} → {newStatus}"

        except Exception as e:
            connection.rollback()
            raise
        finally:
            cursor.close()
            connection.close()


    def _send_teams_update(varLib, project_name, previous_status, new_status, updated_by, notes):
        """Helper function to send Teams notification."""
        import requests
        import json

        variables = varLib.getVariables()
        webhook_url = variables.get("TEAMS_WEBHOOK_URL")
        report_url = variables.get("POWERBI_REPORT_URL")

        if not webhook_url:
            return

        adaptive_card = {
            "type": "message",
            "attachments": [{
                "contentType": "application/vnd.microsoft.card.adaptive",
                "content": {
                    "$schema": "http://adaptivecards.io/schemas/adaptive-card.json",
                    "type": "AdaptiveCard",
                    "version": "1.4",
                    "body": [
                        {
                            "type": "TextBlock",
                            "size": "Large",
                            "weight": "Bolder",
                            "text": "📋 Project Status Update"
                        },
                        {
                            "type": "FactSet",
                            "facts": [
                                {"title": "Project:", "value": project_name},
                                {"title": "Status:", "value": f"{previous_status} → {new_status}"},
                                {"title": "Updated By:", "value": updated_by}
                            ]
                        },
                        {
                            "type": "TextBlock",
                            "text": f"**Notes:** {notes}" if notes else "",
                            "wrap": True
                        }
                    ],
                    "actions": [
                        {"type": "Action.OpenUrl", "title": "View Project", "url": report_url}
                    ] if report_url else []
                }
            }]
        }

        requests.post(webhook_url, headers={"Content-Type": "application/json"},
                      data=json.dumps(adaptive_card), timeout=30)


    @udf.connection(argName="sqlDb", alias="ProjectTrackingDb")
    @udf.connection(argName="varLib", alias="ProjectVariables")
    @udf.function()
    def request_status_update(
        sqlDb: fn.FabricSqlConnection,
        varLib: fn.FabricVariablesClient,
        projectId: int,
        requestedBy: str,
        message: str
    ) -> str:
        """
        Sends a Teams notification requesting a status update for a project.
        """
        logging.info(f"Requesting status update for Project ID: {projectId}")

        connection = sqlDb.connect()
        cursor = connection.cursor()

        try:
            # Get project details
            cursor.execute("""
                SELECT [Project name], [Project manager]
                FROM [Project]
                WHERE [Project id] = ?
            """, (projectId,))
            project_row = cursor.fetchone()

            if not project_row:
                raise fn.UserThrownError(f"Project with ID {projectId} not found.")

            project_name = project_row[0]
            project_manager = project_row[1]

            # Get current status
            cursor.execute("""
                SELECT TOP 1 [Status], [Updated date]
                FROM [Status updates]
                WHERE [Project id] = ?
                ORDER BY [Update id] DESC
            """, (projectId,))
            status_row = cursor.fetchone()
            current_status = status_row[0] if status_row else "Not Started"
            last_updated = status_row[1].strftime("%Y-%m-%d") if status_row else "Never"

            # Send Teams notification
            _send_status_request(varLib, project_name, project_manager,
                                current_status, last_updated, requestedBy, message)

            return f"Status update requested for '{project_name}' from {project_manager}"

        finally:
            cursor.close()
            connection.close()


    def _send_status_request(varLib, project_name, project_manager, current_status,
                            last_updated, requested_by, message):
        """Helper function to send status update request via Teams."""
        import requests
        import json

        variables = varLib.getVariables()
        webhook_url = variables.get("TEAMS_WEBHOOK_URL")
        report_url = variables.get("POWERBI_REPORT_URL")

        if not webhook_url:
            return

        adaptive_card = {
            "type": "message",
            "attachments": [{
                "contentType": "application/vnd.microsoft.card.adaptive",
                "content": {
                    "$schema": "http://adaptivecards.io/schemas/adaptive-card.json",
                    "type": "AdaptiveCard",
                    "version": "1.4",
                    "body": [
                        {
                            "type": "TextBlock",
                            "size": "Large",
                            "weight": "Bolder",
                            "text": "📢 Status Update Requested"
                        },
                        {
                            "type": "FactSet",
                            "facts": [
                                {"title": "Project:", "value": project_name},
                                {"title": "Owner:", "value": project_manager},
                                {"title": "Current Status:", "value": current_status},
                                {"title": "Last Updated:", "value": last_updated},
                                {"title": "Requested By:", "value": requested_by}
                            ]
                        },
                        {
                            "type": "TextBlock",
                            "text": f"**Message:** {message}" if message else "",
                            "wrap": True
                        }
                    ],
                    "actions": [
                        {"type": "Action.OpenUrl", "title": "Update Status", "url": report_url}
                    ] if report_url else []
                }
            }]
        }

        requests.post(webhook_url, headers={"Content-Type": "application/json"},
                      data=json.dumps(adaptive_card), timeout=30)

  3. Configure the connections:

    • Select Settings or the connections panel.
    • Add connection ProjectTrackingDb pointing to your Fabric SQL Database.
    • Add connection ProjectVariables pointing to your Variable Library.
  4. Select Publish to deploy the function.

Note

Functions used with Power BI data function buttons must return a string (-> str). Power BI displays this return value to the user after the function executes, providing feedback about the action's result.

Understand the update_project_status function

The update_project_status function writes a new status record to the SQL database and sends a Teams notification. When a user selects the update button in the report, the following flow occurs:

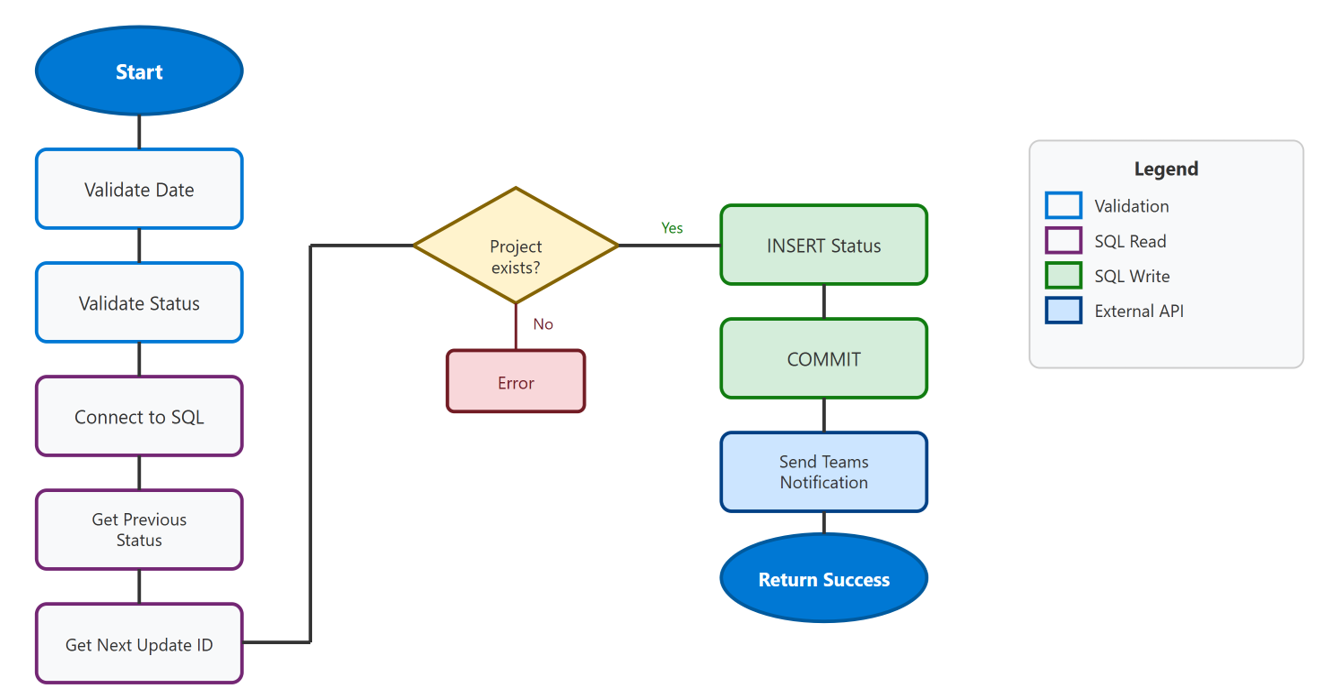

Diagram showing the data flow when updating project status: Power BI calls the function, which writes to the SQL database and sends a Teams notification.

  1. Power BI calls the function - The data function button passes parameters (project ID, new status, notes, etc.) to the user data function.

  2. Validate inputs - The function validates the date format and checks that the status value is one of the allowed options.

  3. Query current state - The function retrieves the previous status and project name from the database.

  4. Insert new record - A new row is inserted into the Status updates table with the new status, timestamp, and notes.

  5. Send Teams notification - The helper function _send_teams_update posts an Adaptive Card to your Teams channel showing the status change.

  6. Return result - The function returns a success message that Power BI displays to the user.

Understand the request_status_update function

The request_status_update function sends a Teams notification asking a project owner to provide a status update. This function doesn't write to the database—it only sends a message.

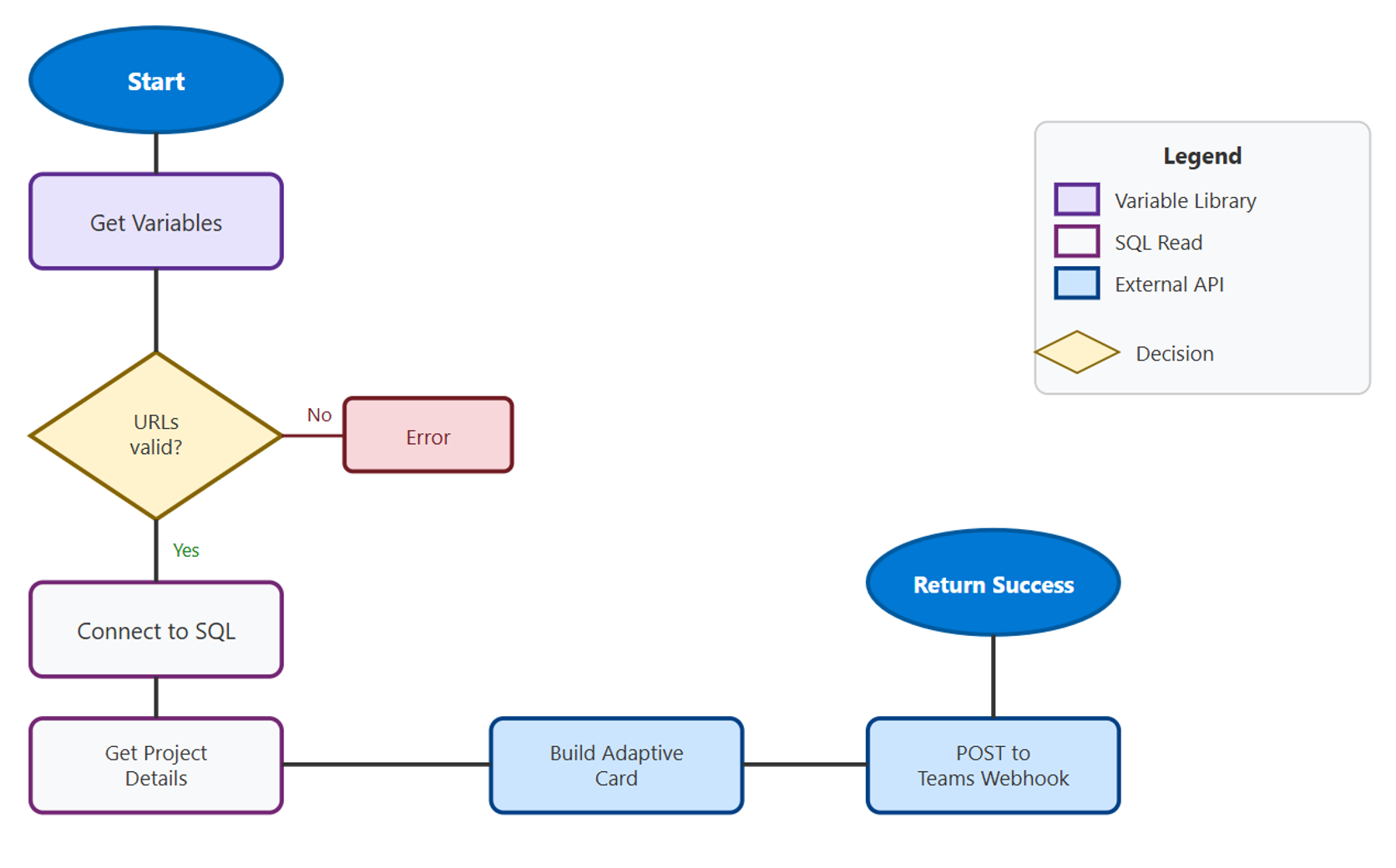

Diagram showing the data flow when requesting a status update: Power BI calls the function, which queries project details and sends a Teams notification.

  1. Power BI calls the function - The data function button passes the project ID, requester name, and message to the function.

  2. Query project details - The function retrieves the project name, project manager, and current status from the database.

  3. Send Teams notification - The helper function _send_status_request posts an Adaptive Card to your Teams channel with the request details and an Update Project Status button that links back to the report.

  4. Return result - The function returns a confirmation message that Power BI displays to the user.

(Optional) Set up Lakehouse shortcuts for Direct Lake views

Fabric SQL Database stores all data as Delta tables in OneLake, so you can create a Direct Lake semantic model directly on the SQL database tables. However, Direct Lake can't read views from a SQL database—only tables. To use a view with Direct Lake, create shortcuts to the SQL database tables in a Lakehouse, then define the view there.

Create shortcuts to the SQL database tables

  1. In your Fabric workspace, create a new Lakehouse and enable schemas.

  2. In the Lakehouse Explorer, right-click any schema (such as dbo) and select New table shortcut.

  3. In the OneLake Catalog, browse to your SQL database and select the Project table.

  4. Repeat to create a shortcut for the Status updates table.

The shortcuts provide read access to the underlying Delta tables without duplicating data.

Screenshot showing the Lakehouse options for adding shortcuts and materialized lake views.

Create a materialized lake view

Create a materialized lake view in the Lakehouse that computes the latest status for each project:

  1. In the Lakehouse, select Manage materialized lake views (preview).

  2. Open a new notebook with Spark SQL.

  3. Run the following query:

    CREATE MATERIALIZED LAKE VIEW IF NOT EXISTS dbo.project_status AS
    SELECT
        p.`Project id` AS ProjectId,
        p.`Project name` AS ProjectName,
        COALESCE(ls.LatestStatus, 'Not Started') AS LatestStatus,
        ls.LatestNotes
    FROM dbo.Project p
    LEFT JOIN (
        SELECT
            `Project id` AS ProjectId,
            `Status` AS LatestStatus,
            `Notes` AS LatestNotes,
            ROW_NUMBER() OVER (PARTITION BY `Project id` ORDER BY `Update id` DESC) AS RowNum
        FROM dbo.`Status updates`
    ) ls ON p.`Project id` = ls.ProjectId AND ls.RowNum = 1;

  4. Schedule the view refresh by selecting Schedules > On and setting the frequency.

Screenshot showing the materialized lake view schedule and create options.

Note

The SQL database remains the write target for user data functions. The Lakehouse shortcuts provide read-only access for analytics through the materialized lake view.

Create the Power BI report

You can connect to your data using either DirectQuery or Direct Lake:

  • DirectQuery to SQL Database: Real-time data supports write-back through user data functions.
  • Direct Lake to SQL Database tables: Fabric SQL Database stores data as Delta tables in OneLake, so Direct Lake can read tables directly.
  • Direct Lake via Lakehouse (for views): Direct Lake can't read views from SQL Database. To use views with Direct Lake, create shortcuts to the SQL database tables in a Lakehouse, then define materialized lake views there.

Tip

Import mode can also be used—there's no limitation on storage mode. With Import, the semantic model must be refreshed before updated values appear in the report.

Option A: Connect via DirectQuery

  1. Open Power BI Desktop.

  2. Select OneLake catalog.

  3. Find your Fabric SQL database.

  4. Select Connect to SQL analytics endpoint.

  5. Select the Project, Status updates, and Project status tables/view.

  6. When prompted for storage mode, select DirectQuery.

Screenshot showing the DirectQuery semantic model in Power BI.

Option B: Connect via Direct Lake (for analytics performance)

  1. In the Power BI service, select Create > OneLake catalog.

  2. Find your Lakehouse.

  3. Select the shortcut tables (Project, Status updates) and the materialized lake view (project_status).

  4. Edit the semantic model in the web modeling experience to add measures and relationships.

Note

With Direct Lake, column names from the materialized lake view don't have spaces (for example, ProjectId instead of Project id). Rename the columns in the semantic model to match your measures.

Screenshot showing the Direct Lake semantic model in Power BI.

Create the Status Options calculated table

Create a calculated table that provides the status values for the button slicer. Run this TMDL script in Power BI Desktop:

createOrReplace

	table 'Status Options'

		column Status
			summarizeBy: none
			isNameInferred
			sourceColumn: [Status]
			sortByColumn: 'Sort Order'

		column Description
			summarizeBy: none
			isNameInferred
			sourceColumn: [Description]

		column 'Sort Order'
			isHidden
			formatString: 0
			summarizeBy: sum
			isNameInferred
			sourceColumn: [Sort Order]

		column 'Status Color'
			summarizeBy: none
			isNameInferred
			sourceColumn: [Status Color]

		partition 'Status Options' = calculated
			mode: import
			source =
				DATATABLE(
				    "Status", STRING,
				    "Description", STRING,
				    "Sort Order", INTEGER,
				    "Status Color", STRING,
				    {
				        { "Not Started", "Project has been created but work has not begun", 1, "#808080" },
				        { "In Progress", "Active work is being performed on the project", 2, "#0078D4" },
				        { "On Hold", "Project is paused pending resources, decisions, or dependencies", 3, "#FFB900" },
				        { "Completed", "All project deliverables have been finished", 4, "#107C10" },
				        { "Cancelled", "Project has been terminated and will not be completed", 5, "#D13438" }
				    }
				)

Create supporting measures

Create a calculated table to hold the measures that support the data function buttons. Run this TMDL script in Power BI Desktop:

createOrReplace

	table 'Translytical task flow'

		/// Generates a preview of the Teams notification that will be sent when the user updates the status. Shows a warning if required selections are missing.
		measure 'Preview of status update' = ```
				VAR _ProjectId = SELECTEDVALUE(Project[Project id], 0)
				VAR _ProjectName = SELECTEDVALUE(Project[Project name], "")
				VAR _PreviousStatus = [Latest Status]
				VAR _NewStatus = SELECTEDVALUE('Status Options'[Status], "N/A")
				VAR _UpdatedBy = [Updated by]
				VAR _UpdatedDate = FORMAT(NOW(), "YYYY-MM-DD HH:mm")
				VAR _NL = UNICHAR(10)
				RETURN
				IF(_ProjectId = 0 || _NewStatus = "N/A",
				    "⚠️ Select a project and new status to preview",
				    "📋 Teams Notification Preview" & _NL &
				    "━━━━━━━━━━━━━━━━━━━━" & _NL &
				    "Project: " & _ProjectName & _NL &
				    "Status: " & _PreviousStatus & " → " & _NewStatus & _NL &
				    "Updated By: " & _UpdatedBy & _NL &
				    "Date: " & _UpdatedDate & _NL &
				    "Notes: See above" & _NL &
				    "━━━━━━━━━━━━━━━━━━━━" & _NL &
				    "📨 This will be sent to Teams"
				)
				```

		/// Returns the email address of the current user. Used to track who made each status update.
		measure 'Updated by' = USERPRINCIPALNAME()

		/// Returns the most recent notes for the selected project. Only evaluates when a project is in scope.
		measure 'Latest notes' =
				IF(ISINSCOPE(Project[Project name]),
				LASTNONBLANKVALUE('Status updates'[Update id], MAX('Status updates'[Notes])),
				BLANK())

		/// Returns the most recent status for the selected project by finding the last non-blank status value.
		measure 'Latest status' =
				IF(HASONEVALUE(Project[Project id]),
				LASTNONBLANKVALUE('Status updates'[Update id], MAX('Status updates'[Status])),
				BLANK())

		/// Returns the Project ID when a single project is selected. Used as a parameter for the update_project_status and request_status_update functions.
		measure 'Selected project id' = SELECTEDVALUE(Project[Project id])
			formatString: 0

		/// Returns today's date in ISO format. Used as the timestamp for status updates.
		measure 'Updated date' = FORMAT(TODAY(), "yyyy-mm-dd")

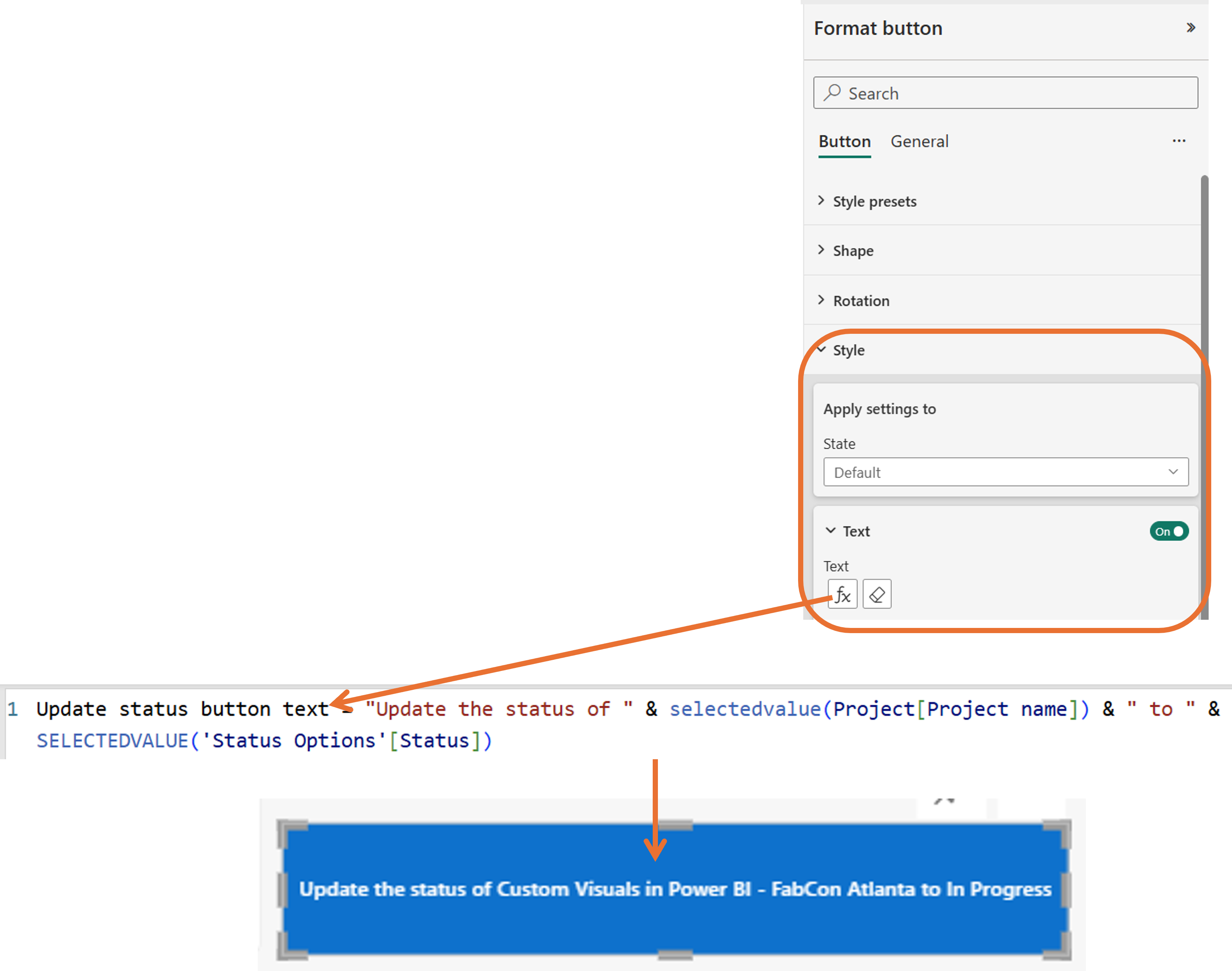

		/// Provides dynamic text for the update button showing the selected project and new status.
		measure 'Update status button text' = "Update the status of " & SELECTEDVALUE(Project[Project name]) & " to " & SELECTEDVALUE('Status Options'[Status])

		column Value
			isHidden
			formatString: 0
			summarizeBy: sum
			isNameInferred
			sourceColumn: [Value]

		partition 'Translytical task flow' = calculated
			mode: import
			source = {1}

Note

This script creates the Translytical task flow table with a hidden column. Hiding all columns converts it to a measure table, which displays a special icon and always appears at the top of the Data pane for easy access.

These measures serve multiple purposes:

Measure Purpose
Selected project id Captures the Project ID when a single project row is selected. Passed as a parameter to the user data functions.
Updated by Returns the current user's email via USERPRINCIPALNAME(). Tracks who made each status update.
Updated date Returns today's date in ISO format (yyyy-mm-dd) for the function timestamp parameter.
Update status button text Provides dynamic button labeling showing the selected project and new status (for example, "Update the status of Session ABC to In Progress").
Latest status Shows the most recent status for a project using LASTNONBLANKVALUE to find the last entry in the Status updates table.
Latest notes Shows the most recent notes for a project. Only evaluates when a specific project is in scope.
Preview of status update Generates a preview of the Teams notification before sending, helping users confirm their changes. Shows a warning if selections are missing.

Design the report

The report layout guides users through a clear workflow: select a project, choose a new status, add notes, then execute the update.

Screenshot showing the complete Power BI report design with project table, status slicer, notes input, and action buttons.

Create the project table

  1. Add a Table visual to display project information.

  2. Add these columns from your data:

    • Product name
    • Project name
    • Target end date
    • Description
    • Latest status (from the Status or Project status table/view)
    • Latest notes
  3. Set the title to 1) Pick a project to update.

  4. Sort by Target end date ascending to show upcoming deadlines first.

Create the button slicer for status selection

  1. Add a Button slicer visual.

  2. In the Values field, add Status Options[Status].

  3. In the Label field, add FIRST(Status Options[Description]) to show the description beneath each status.

  4. In the Format pane:

    • Set Style to Cards.
    • Set Orientation to Horizontal.
    • Set Max tiles to 5 (one for each status).
  5. Configure conditional formatting to color each card by the Status Color field.

  6. Set the title to 2) Pick a new status.

Add input slicers for notes

  1. Add an Input slicer for users to enter notes about the status update.

  2. Set the title to 3) Add notes for this status update.

  3. Add another input slicer for the message field used by the request status update button.

  4. Set the title to Or send a message to the teams channel.

Tip

Give each input slicer a descriptive title. When you configure a data function button, slicers appear in the parameter dropdown by their title, making it easier to identify the correct one. After configuration, you can hide the title on the report canvas if needed.

Add the preview table

  1. Add a Table visual with a single column: the [Preview of status update] measure.

  2. Set the title to Preview update.

This shows users what their Teams notification will look like before they send it.

Add the data function buttons

Add two buttons: one for updating status and one for requesting a status update.

Update status button

  1. In the Insert tab, select Button > Data function.

  2. In the Format pane, configure the button text:

    • Set Default text to your [Update status button text] measure for dynamic labeling.
    • Set Disabled text to static text like "Pick a project, new status, and add notes first".
  3. Select your published update_project_status function.

  4. Map the function parameters:

    Parameter Binding type Bound to
    projectId Measure [Selected project id] measure
    newStatus Slicer Button slicer visual (auto-clear enabled)
    updatedBy Measure [Updated by] measure
    notes Slicer Input slicer visual (auto-clear enabled)
    updatedDate Measure [Updated date] measure
  5. In the Format pane under Action, enable Refresh the report after successful outcome. This setting automatically refreshes the report page after the function executes successfully.

    Tip

    Enable Auto-clear for slicer parameters so the button slicer and notes text reset after the user triggers the function.

Note

The Refresh the report after successful outcome toggle only refreshes the report page when the function runs successfully. For DirectQuery and Direct Lake storage modes, the refreshed page shows updated data immediately. For Import mode, the semantic model must be refreshed separately before the updated values appear in the report.

Screenshot showing the update project status button in the Power BI report.

Request status update button

  1. Add another Button > Data function.

  2. In the Format pane, configure the button text:

    • Set Default text to static text like "Send Teams message to channel".
    • Set Disabled text to "Pick a project and type in a message first".
  3. Select your published request_status_update function.

  4. Map the function parameters:

    Parameter Binding type Bound to
    projectId Measure [Selected project id] measure
    requestedBy Measure [Updated by] measure
    message Slicer Input slicer visual (auto-clear enabled)
  5. Optionally enable Refresh the report after successful outcome in the Format pane under Action.

Screenshot showing the send Teams message button in the Power BI report.

Configure dynamic button text

Use dynamic text on your data function buttons to show users exactly what action will occur when they select the button. Instead of a generic label like "Update," the button can display context-specific text like "Update the status of Session ABC to In Progress."

To configure dynamic button text:

  1. Create a measure that generates the button label. For example, this measure combines the selected project name and new status:

    Update status button text =
        "Update the status of " & SELECTEDVALUE(Project[Project name]) & " to " & SELECTEDVALUE('Status Options'[Status])

  2. In the Format pane for the data function button, expand Button > Text.

  3. Set Default text to your dynamic measure ([Update status button text]).

  4. Set Disabled text to static text that tells users what selections are required (for example, "Pick a project, new status, and add notes first").

The button displays the disabled text until all required parameters have values. Once the user makes their selections, the button shows the dynamic text describing the specific action.

Screenshot showing the button format pane with dynamic text configuration using a measure for default text and static text for disabled state.

(Optional) Add a drill-through button and page

You can add a drill-through page to show the full history of status updates for a selected project.

  1. In the Insert tab, select Button > Blank.

  2. In the Format pane under Button, set the text:

    • Default text: "See all status updates"
    • Disabled text: "Pick a project to see all status updates"
  3. Under Action, enable the action and set:

    • Type: Drillthrough
    • Destination: Select your status history page (created in the next steps)
  4. Add a new page and name it Status update history.

  5. In the Format pane for the page, expand Page information and enable Drillthrough. Add Project[Product name] as the drillthrough field.

  6. Add visuals to display the status history:

    • Card: Total count of status updates
    • Button slicer: Breakdown by status
    • Table: All status updates (Update id, Updated date, Status, Notes, Updated by)
    • Line chart: Update activity over time
  7. Add a Back button so users can return to the main report page. In the Insert tab, select Button > Back.

Publish the report

  1. Save your report and publish it to the Power BI service.

  2. Copy the report URL and add it to your variable library as POWERBI_REPORT_URL.

Test the workflow

Test the request status update flow

Once published, you can use the translytical task flow to request a status update:

Screenshot showing the numbered steps for requesting a status update: 1) select a project, 2) enter a message, 3) select Send teams message to channel, 4) see confirmation, 5) Teams notification appears with Update Project Status button.

  1. Pick a project to update - Select a project row in the table to set the filter context.

  2. Or send a message to the teams channel - Enter a message in the input slicer (for example, "Can we get an update on this?").

  3. Select the Send teams message to channel button.

  4. A Request submitted confirmation appears when the action completes successfully.

  5. Check your Teams channel for the Project Status Update Adaptive Card with the request details.

  6. The project owner can select Update Project Status in the Adaptive Card to open the report and update their status.

Screenshot showing the Adaptive Card notification in Teams requesting a status update with the Update Project Status button.

Test the update status flow

Once published, you can use the translytical task flow to update a project status:

Screenshot showing the numbered steps for updating a project status: 1) select a project, 2) choose a status, 3) add notes, 4) select Update, 5) see confirmation, 6) Teams notification appears.

  1. Pick a project to update - Select a project row in the table to set the filter context.

  2. What is the new status? - Use the button slicer to select a new status (for example, In Progress).

  3. Add notes for this status update - Enter notes in the input slicer (for example, "Started to record demo").

  4. Select the Update button to write the status change back to the lakehouse and send a Teams notification.

  5. A Request submitted confirmation appears when the action completes successfully.

  6. Check your Teams channel for the Project Status Update Adaptive Card with the status change details.

Screenshot showing the Adaptive Card notification in Teams after a status update.

Translytical task flows

Report visuals

DAX functions

Fabric data

Microsoft Teams
